Excavation and Foundation

When excavating the ground to prepare the foundation, the excavating slope should be 1:1 or 1:1.5 and, if the slope is high, a bench should be prepared for stable slope.
The width of a bench should be about 3.0m; the width of excavating bottom should be larger than the width of steel structure by at least 3.0m; excavating depth should be larger compared with the position of installed structure by at least 0.5m; on the stable ground, no replacement is needed and only hardening process performed. Things regarding soil cut and hardening shall conform to the related regulations of domestic specifications.
Bedding

Bedding is essentially required for foundation of circular structures and plays the role of a cushion between the foundation and steel material; the material same as the basic material should be used and loosened and fine sands should be sprayed to the about 70-100mm of space contacting with steel plate so that the wave of steel plate may closely contact with the bed.
Corrugated steel plate is the one that anticorrosive property is improved with galvanization; care should be taken to avoid possible scratch of the surface; after installation, no rough gravel should be used in the space contacting with steel plate and bed.
The thickness of bed should be about 60cm from the lower end of steel plate; the material same as the foundation should be used in hardening; the part adjacent to steel plate should be lightly hardened using the sand/gravel (1/2 of the wave size of steel plate) or sand.
The width of bed should be similar with the distance between the parts where curvature radius is changed and, in case of circular structures, the bed should be formed with the margin that hardening of the haunch of steel plate is not difficult. Bedding is more required when the curvature of lower steel plate is large; as hardening the haunch is difficult, the bed should be formed to meet the curvature radius so that construction may easily be performed.

Foundation of Bridge Plate

Bridge Plate is built on the concrete foundation consisted of C-shaped base channels and anchor bolts. In case of open cross section (arch-type cross section), the foundation concrete structure should be installed at the accurate position to support the steel plate walls and the distance between anchoring channels should be confirmed with measurement.
- Steel plates and foundation concrete are connected using anchoring channels.
- Anchoring channels are installed with burying anchors before spraying concrete and, after spraying concrete, anchored connection angles may be used.
- Anchoring channels should be connected with steel plates at a right angle.

Assembling and Installation of Bridge Plate

Fixon manufactures Bridge-plate under the strict quality control; the produced panels are packaged in sets for convenient construction work; and the parts to be assembled are packaged in separate boxes and supplied to the site.
As each Bridge-plate has printed number on its surface according to the assembling sequence so that classification and assembling may easily be done; the detailed specifications supplied with installation design together have detailed information on construction to help rapid construction work.
Panels may be partially assembled and then may be moved to the installation site for connection and construction work at the site, to meet the situation of the site.
As assembling method may be different depending upon the situation of site, the method should be decided through discussion with the field supervisor or representative.

Details of overlapped bolt for connection of corrugated steel plates
[Brief drawing of details of Bridge Plate assembling]
Final Treatment

In order to prevent distortion or damage to the tip of the structure, we treat the tips with concrete to keep shape of the angle or the structure. The treatment of overlapped panels also reinforces the structure.
Headwall options

- Concrete cast
- precasted concrete panel
- piled panel
- stoney breast wall
- Gabion
- Corrugated steel plate
Headwalls treated with impervious materials prevent the entrance ground from erosion and blocking.

Backfill

1) Materials for backfilling must be same as the aggregate described on the specification.

- Materials should be febbles, sands, slag, and shattered stone which are strong and durable and the mixed aggregate proved by the inspector and silt. The materials should not contain the impurities and must be qualified. Materials should be in regular shape. If you want to change or alter the materials, approval from the inspector is needed.

SB-1 qualification

Section Test method Criteria
Liquid limit KS F 2303 Less than 25
Less than 25 KS F 2508 Less than
Abrossion loss KS F 2304 Less than
Plasticity(%) KS F 2320 Over 30
Sand equivalent value of soil KS F 2340 Over 25
But, the CBR of the SB-1 should be more than 80

- Selecting Materials
Before choosing materials for SB-1, purchaser should get permission from the inspector.

Purchasing Subbase Course

Purchase number permiability
100mm 75mm 53mm 37.5mm 19mm 4.75mm
(No.4)
2.0mm
(No.10)
425§­
(No.40)
75§­
(No.200)
SB-1
SB-2
  100 -
100
70-100
80-100
50-90
55-100
30-65
30-70
20-55
20-55
5-25
5-30
2-10
2-10

Backfilling material
The size of backfilling materials within the 300mm from the structure should not exceed 75mm
Backfilling process
- Heavy equipment handlers should follow the work range by the technician to avoid the impact from the equipment.
- Unloading backfilling material on the upper part of the structure is prohibited but on the lateral part.
- Use compacting machine to compact the soil.
- Trucks or heavy equipment should be away from the distance from the structure that is proposed by specification.
- Thickness of layer compacted by vibrating machine should be less than 200mm. In order to lessen the longitudinal impact from the end of the structure, compacting machine should keep away from the end of the structure.

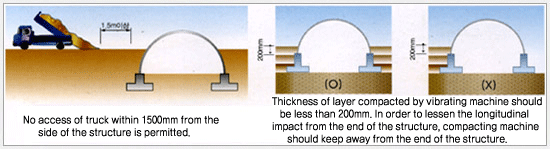

- No access of truck within 1500mm from the side of the structure is permitted.
- Backfilling layers should be compacted one by one, in an order of ¡°left and right¡± or ¡°right and left¡±, The gap of the left and right layer thickness should not be over 400mm.



3. Compaction.

- Use a vibrating machine or portable compacting machine to compact the soil in a longitudinal way.
- Backfilling material should contain appropriate amount of water retention according to the specification.
- Compaction density of each layer is at least 95%.
- Accessibility of the upper part of the structure.

4. Accessibility of the upper part of the structure
- Regarding backfilling at the 3/4 height of Rise, backfilling materials are unloaded on the crown part of the structure and start backfilling across the structure.
- Backfilling of the upper part of the structure must be done under the supervision of the instructor.
- There is non-compaction area of 600m between the upper part and the equipment on both sides of the structure.
- The equipment for unloading backfilling materials should not be heavier than D-4 caterpillar dozer, which is 7 metric tons. Compacting equipment should not be heavier than BWW-775.
- Thickness of layer compacted by vibrating machine should be less than 200mm. In order to lessen the longitudinal impact from the end of the structure, compacting machine should keep away from the end of the structure.
